A Worker Camp Is a System, Not a Row of Detachable Cabins

July 22, 2026

A Worker Camp Is a Small City With a Project Deadline

A worker camp is often purchased as if it were a collection of rooms. The project team calculates the expected headcount, chooses a room size, divides the population by the number of beds per cabin and sends suppliers a request for a certain quantity of accommodation units. That method produces a cabin schedule. It does not produce a functioning camp.

A real detachable modular worker camp is a temporary settlement with a fixed operational purpose. People must sleep, wash, eat, travel to work, recover from shifts, obtain medical assistance, communicate with their families, store personal belongings and live under rules that remain workable for months or years. At the same time, the camp must receive food, water, fuel, replacement parts and waste services. It must control fire, drainage, security, noise, hygiene and maintenance. It must expand when the workforce grows and contract when the project enters demobilization.

This is why the first camp question should not be “How many cabins do we need?” It should be “What human and infrastructure system must operate every day, at every shift change and during every credible disruption?”

The distinction is commercially important. A low-priced accommodation package can become an expensive project when sanitary capacity is undersized, dining halls create long queues, water storage cannot cover interruptions, service vehicles conflict with pedestrians or future expansion blocks emergency access. These are not separate problems added after the buildings arrive. They are consequences of treating a settlement as a product order.

This article explains how project owners, EPC contractors, mining companies, infrastructure developers and international buyers can plan a camp as one coordinated operating system. The focus is not on promoting one standard cabin. It is on connecting population, layout, buildings, utilities, services, management and lifecycle decisions before procurement begins.

Begin With the Population Clock, Not the Bed Count

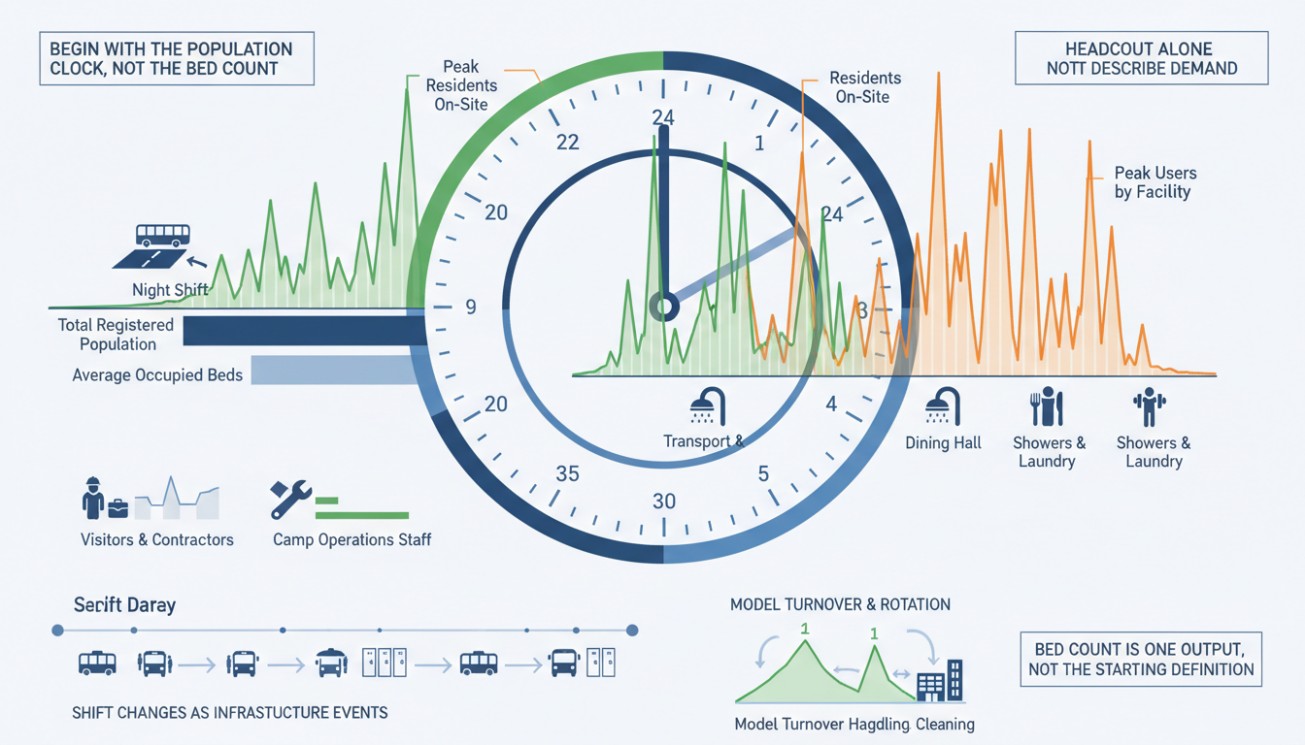

Population clock model showing worker camp occupancy, shift changes and peak demand for transport, dining, showers and laundry

Headcount is necessary, but headcount alone does not describe demand. Two camps with 800 residents may require very different buildings and infrastructure if one serves a single daytime construction workforce and the other supports a 24-hour mining operation with rotating crews.

Good worker camp planning begins with a population clock: a time-based model showing who is present, awake, eating, washing, traveling, working or sleeping during each part of the day.

Separate Nominal Capacity From Peak Occupancy

The maximum number of residents is not always the number using every facility at the same time. Sleeping rooms may remain fully occupied across multiple shifts, while dining, showers, transport and recreation experience short peaks. Capacity calculations should therefore distinguish:

  • Total registered population.
  • Average occupied beds.
  • Peak residents on site.
  • Peak users by facility.
  • Visitors, contractors and temporary staff.
  • Camp operations personnel who are not part of the production workforce.

Map Shift Changes as Infrastructure Events

A shift change can release hundreds of people into the same circulation network. Buses arrive. Workers return protective equipment. Dining demand rises. Showers and laundry use increase. Security gates and medical facilities may experience higher traffic.

If the camp is designed from daily averages, these short periods can overload the system. The population clock should identify the fifteen-minute, thirty-minute and one-hour peaks that control entrances, dining seats, hot-water recovery, sanitary demand and internal transport.

Define the Workforce Profile

Workers are not an interchangeable population. The brief should consider gender mix, cultural and religious needs, age range, accessibility requirements, supervisory staff, visiting specialists, families where applicable and the expected level of privacy.

This does not mean creating unnecessary complexity. It means preventing a nominally efficient design from excluding part of the workforce or creating avoidable conflicts in sanitary, sleeping, recreation and dining areas.

Model Turnover and Rotation

Remote projects often operate with roster systems. Residents arrive and leave in cycles, creating demand for reception, baggage handling, room changeover, cleaning, linen, transport and access control. A camp designed only for steady-state occupancy may fail during crew rotations.

The population clock becomes the demand engine for the entire remote workforce accommodation system. Bed count is one output, not the starting definition.

Seven Systems Must Arrive Together

A camp becomes operational only when seven systems work together. The modular buildings are visible, but several less visible networks determine whether the camp remains safe, hygienic and efficient.

1. Accommodation System

This includes sleeping rooms, storage, supervisor accommodation, accessible rooms, housekeeping stores, linen handling and the paths residents use between rooms and shared facilities.

2. Water, Sanitation and Hygiene System

This system includes water source, treatment, storage, distribution, hot water, toilets, showers, handwashing, laundry, wastewater collection, treatment or disposal, cleaning and hygiene management.

3. Food and Nutrition System

Food service begins at delivery and continues through inspection, dry and cold storage, preparation, cooking, serving, dining, washing, grease management, waste storage and pest control.

4. Utility and Environmental System

Power generation or grid supply, fuel, backup power, communications, drainage, stormwater, solid waste, lighting and environmental monitoring form the camp’s technical backbone.

5. Health, Safety and Emergency System

Medical rooms, first aid, fire detection, firefighting access, evacuation, emergency assembly, incident response and occupational health interfaces must be planned as one network.

6. Movement, Security and Access System

This system separates pedestrians, buses, service trucks, emergency vehicles, deliveries, waste collection and restricted zones. It also manages reception, identification, visitor control and secure storage.

7. Social and Management System

Recreation, communication, religious space, quiet areas, grievance channels, camp rules, maintenance reporting, cleaning standards and resident engagement influence whether the settlement remains stable over time.

These systems explain why a modular labor camp cannot be designed by repeating one room module across a drawing. The room is only one node in a much larger network.

Masterplan the Camp Before Scheduling the Modules

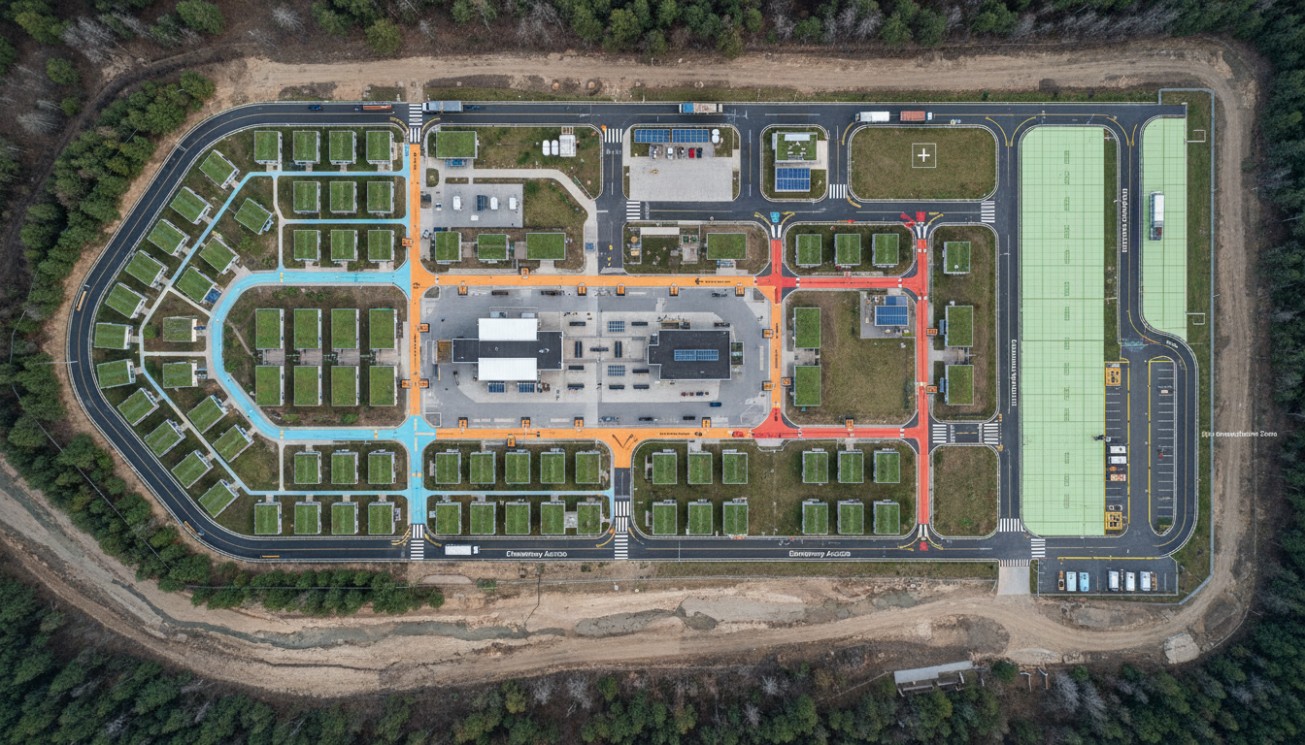

Top-down worker camp masterplan separating accommodation, central services, recreation, roads and service access

The camp masterplan converts operational demand into land use, circulation and infrastructure. A strong plan can accommodate changes without losing emergency access or forcing expensive utility reconstruction. A weak plan can make even high-quality modules difficult to operate.

Screen the Site Before Optimizing the Layout

The site should be reviewed for drainage, flood exposure, prevailing winds, dust, noise, topography, soil, access roads, utility corridors, nearby industrial hazards and potential expansion. The cheapest available land can become the most expensive camp if it requires major earthworks, long utility runs or constant water management.

Climate and exposure should be translated into the building specification rather than treated as background information. The site's guide to detachable modular building climate design explains how heat, humidity, snow, wind, salt and condensation change the structure and enclosure.

Create Quiet, Active and Service Zones

Sleeping areas should be protected from kitchens, generators, workshops, bus loading, waste yards and entertainment spaces. The objective is not simply distance. Wind direction, barriers, operating hours and traffic paths also affect noise, odor and disturbance.

A practical camp often contains:

  • Accommodation neighborhoods.
  • Dining and central services.
  • Administration and reception.
  • Medical and emergency functions.
  • Recreation and social areas.
  • Utility and maintenance zones.
  • Delivery, waste and service yards.
  • Future expansion zones.

Separate People From Service Traffic

Food deliveries, waste vehicles, fuel trucks, maintenance equipment and buses should not rely on the same paths used by residents walking between rooms, dining halls and work transport. Where crossing is unavoidable, visibility, speed control, lighting and time separation should be designed.

Design Emergency Access as a Permanent Clear Zone

Emergency routes are often clear in the first drawing and gradually consumed by parked vehicles, storage, added modules or temporary shelters. The masterplan should protect access geometrically and operationally.

Reserve the Exit Before Building the Entrance

Camp planning usually emphasizes mobilization. Demobilization deserves equal attention. Modules need removal paths, crane access, sorting areas and a sequence that allows part of the camp to keep operating while other zones are dismantled.

This is one of the strongest reasons to use a documented system of detachable modular buildings: the layout can be organized around repeatable interfaces, but only when expansion and removal are considered from the beginning.

A Bed Is a Quantity; a Room Is a Living Environment

Procurement schedules often treat sleeping accommodation as a simple ratio: beds per room multiplied by room count. Real workforce housing design must consider recovery, privacy, storage, cleaning, noise, ventilation and the ability to maintain the room while occupied.

Occupancy Density Changes More Than Comfort

More beds increase heat, moisture, personal storage, cleaning demand, electrical use and evacuation complexity. A room layout that fits geometrically may still be operationally weak if occupants cannot store workwear, dry clothing or move without disturbing others.

Storage Is Part of the Room Program

Workers may need separate locations for clean clothing, personal items, luggage, footwear and work equipment. When storage is omitted, corridors, bed areas and ventilation paths become informal storage zones.

Shift Work Requires Acoustic and Light Control

Day sleepers need protection from traffic, housekeeping, doors, outdoor lighting and neighboring activities. Room placement, corridor design, door seals, wall construction and camp rules all contribute to sleep quality.

Housekeeping Must Be Designed In

Rooms require cleanable surfaces, accessible corners, durable hardware and a practical process for linen change, waste removal and maintenance reporting. A visually attractive interior that is difficult to clean will lose quality quickly under intensive use.

Accessible Accommodation Should Connect to an Accessible Camp

An accessible room has limited value if dining, medical, sanitation, administration and transport stops cannot be reached. The route, gradient, surface, doorway and emergency plan must connect the complete journey.

The same room module may serve accommodation, administration or support functions, but its occupancy and service requirements should be defined before manufacture. A product label such as “standard dormitory cabin” is not a complete room brief.

WASH Is a Capacity Chain, Not a Toilet Schedule

WASH capacity chain showing water sourcing, treatment, storage, distribution, hygiene facilities and wastewater management for a modular camp

Water, sanitation and hygiene failures can close facilities, create health risks and damage confidence in the entire project. Yet WASH is often procured as a number of toilet and shower cabins.

A functioning system must connect every stage:

Source → treatment → storage → distribution → hot-water production → fixtures → collection → treatment or disposal → monitoring and maintenance.

Start With Source Reliability

The project should define whether water comes from a municipal connection, borehole, tanker, surface source or combined system. Quantity, quality, seasonal variation and delivery interruption determine treatment and storage requirements.

Size for Peak Use and Recovery

Showers, handwashing, laundry and kitchens may peak after shifts. Hot-water systems should be evaluated by recovery rate, distribution loss and simultaneous use rather than tank volume alone.

Locate Sanitary Facilities Around Real Walking Patterns

Distance, lighting, privacy, weather protection, accessibility and night-time safety influence whether facilities are convenient and usable. Centralizing every sanitary function may simplify utilities but create long walks and congestion.

Design Cleaning and Consumable Logistics

Every sanitary block needs cleaning access, janitorial storage, replacement consumables, drainage and a method for taking fixtures out of service without closing the entire zone.

Treat Wastewater as a Project Constraint

Wastewater capacity should follow actual population, kitchens, laundry, infiltration and stormwater separation. A camp cannot expand safely when accommodation grows faster than wastewater treatment or disposal capability.

This is why modular camp infrastructure should be designed in expandable capacity blocks. Buildings can be added quickly; water and wastewater systems must be able to grow with them.

The Dining Hall Is the Center of a Supply Chain

Food service is one of the largest daily interfaces between the camp and every resident. Poor planning creates queues, hygiene risk, excessive waste and dissatisfaction even when sleeping rooms perform well.

Calculate Meal Waves, Not Only Daily Meals

A kitchen may be capable of producing enough meals per day but still fail when several shifts require service within a short window. Seating turnover, serving-line capacity, tray return, dishwashing and cleaning must match the meal wave.

Separate Clean and Dirty Movement

Deliveries, food preparation, cooked food, diners, used utensils and waste should follow controlled paths. Cross-traffic increases operational complexity and contamination risk.

Protect the Cold Chain

Receiving inspection, refrigerated storage, backup power, temperature monitoring and maintenance response should be included in the camp utility and management plan.

Place Waste and Grease Systems Deliberately

Kitchen waste attracts pests and creates odor. Collection routes should avoid resident circulation and food receiving areas. Grease handling, drainage and cleaning access should be part of the design.

Allow the Menu to Influence the Building

Cooking method, cultural requirements, fresh-food availability and workforce schedule affect kitchen equipment, ventilation, storage and preparation space. A standard kitchen package cannot be evaluated without an operating menu and meal plan.

Utilities Should Be Designed as Resilient Service Levels

Utility design should not begin and end with estimated peak load. The owner should define which services must continue during a failure, for how long and at what reduced operating level.

Power

The electrical model should separate critical, essential and deferrable loads. Medical rooms, emergency lighting, communications, water treatment, wastewater systems, refrigeration and security may require backup even when accommodation cooling or laundry is reduced.

Water

Storage should reflect source interruption, treatment downtime, fire demand where applicable and emergency operating rules. The project should know which activities will be restricted first if supply falls.

Wastewater

Wastewater systems need alarm, maintenance access, bypass or contingency planning and spare-part support. A failure can limit camp occupancy even when every building remains physically usable.

Stormwater and Drainage

Roofs, roads, hardstanding and compacted ground change runoff. Drainage should protect buildings, pedestrian routes, utility equipment and wastewater facilities. Temporary status does not make standing water temporary in its consequences.

Communications

Operational communication, emergency contact, internet access and resident communication with families can all affect camp stability. Communications should be treated as infrastructure, not a late amenity.

Solid Waste

Waste streams may include food, domestic waste, recyclables, maintenance waste, medical waste and hazardous materials. Storage, collection frequency, segregation and destination must be planned.

A serious remote site accommodation proposal should state the service levels, redundancies, storage periods and operating assumptions behind each utility—not only the installed equipment list.

Safety and Dignity Use the Same Masterplan

Safety is not limited to fire extinguishers and warning signs. Dignity is not limited to room finishes. Both are shaped by layout, management and the ability of residents to use facilities without unnecessary risk or loss of privacy.

Fire Strategy

Fire separation, detection, alarm, escape, emergency lighting, firefighting access and assembly areas depend on the completed camp arrangement. Adding modules later should not narrow routes or create unreviewed fire loads.

Medical and First Response

The medical function should match project hazards, population, travel time to external care and operating hours. Ambulance access, communication and referral procedures are as important as the room itself.

Security Without Institutionalizing Daily Life

Access control should protect residents and project assets while maintaining clear rules, privacy and safe movement. Lighting, visibility, reception, perimeter design and staff behavior influence security more than gates alone.

Gender and Privacy

Sleeping, sanitary, changing and recreation arrangements should reflect the actual workforce. Privacy should be designed through location, access, partitions, lighting and management—not addressed only through signage.

Grievance and Resident Feedback

Residents need a practical method to report maintenance, sanitation, food, security and conduct concerns. The system should allow issues to be tracked, escalated and closed without retaliation.

Recreation and Recovery

Long rotations and remote locations can create isolation and fatigue. Exercise, social space, quiet space, outdoor areas and reliable communication support recovery. These functions should be scaled to the population and climate rather than added as symbolic rooms.

Well-planned construction worker accommodation supports the workforce without turning housing into an extension of the production line. The camp exists to help people recover from work, not merely store them between shifts.

Design the Camp in Three Operational Phases

Early mobilization camp with modular cabins, tents, sanitation units, medical support and temporary utilities at a remote site

A camp rarely reaches full population on day one and remains unchanged until closure. The plan should describe mobilization, steady-state operation and demobilization as different configurations.

Phase One: Mobilization

Early facilities may need to support construction crews before permanent utilities or central services are complete. The first phase should include enough administration, sanitation, food, medical and utility capacity to operate safely without relying on future buildings.

Phase Two: Steady State

The camp reaches planned population and normal service levels. Expansion zones, maintenance workshops, stores and management systems become fully active.

Phase Three: Demobilization

Population declines, but service demand does not reduce in a perfectly linear way. A smaller group may still require kitchens, medical support, security, utilities and sanitation. The sequence should allow capacity to contract without leaving occupied zones dependent on isolated infrastructure.

The article on detachable building relocation explains how inspection, dismantling, refurbishment and recommissioning protect the next use. For camps, demobilization should connect directly to the future asset plan.

An 800-Person Camp Example Shows Why Ratios Are Not Enough

Consider a hypothetical remote mining project expecting 800 residents at peak. The workforce operates two production shifts, with contractors and maintenance teams overlapping during changeover. The site is several hours from a major town and relies on a combination of generated power, treated borehole water and on-site wastewater treatment.

A cabin-only request might ask suppliers for 200 four-bed rooms, a kitchen, a dining hall and several sanitary blocks. A system brief asks a different set of questions.

Population Model

  • How many people are sleeping during each shift?
  • How many arrive or leave during roster change?
  • How many supervisors, visitors and camp staff are present?
  • Which residents need accessible or single-occupancy accommodation?

Movement Model

  • Where do buses load and unload?
  • How do pedestrians reach dining and sanitary facilities?
  • Where do food, fuel and waste vehicles travel?
  • Can emergency vehicles reach every accommodation neighborhood?

Service Model

  • What is the largest meal wave?
  • What happens to hot-water demand after each shift?
  • How much water and power must remain available during a supply interruption?
  • Which utility systems need phased redundancy?

Lifecycle Model

  • Which modules move to the second project?
  • Which infrastructure remains site-specific?
  • How will the camp contract during the final year?
  • Where will components be inspected and packed?

The resulting plan may still use 200 room units, but that number now sits inside a controlled operating model. It may also reveal that some shared facilities should be distributed, that the dining strategy needs multiple service waves, that wastewater capacity controls expansion or that the bus yard must move away from sleeping areas.

This is the difference between buying mining camp buildings and designing a mining workforce settlement.

Procure Interfaces, Not Only Buildings

International camp procurement often divides work among a modular manufacturer, civil contractor, utility supplier, kitchen specialist, local installer and camp operator. The main commercial risk lies at the boundaries.

Create an Interface Responsibility Matrix

Every interface should identify the designer, supplier, installer, inspector and final owner. Examples include:

  • Module to foundation.
  • Building plumbing to site network.
  • Building electrical board to site distribution.
  • Kitchen equipment to ventilation and fire systems.
  • Sanitary blocks to water and wastewater.
  • Fire alarm devices to the camp-wide system.
  • Building drainage to stormwater management.
  • Factory documentation to local approval.

Request Capacity Evidence

Suppliers should state the assumptions behind room capacity, utility loads, kitchen output, water treatment, wastewater, HVAC and emergency systems. Equipment nameplates are not a complete capacity model.

Request Phasing Drawings

The proposal should show the camp at mobilization, peak operation and demobilization. This reveals whether future modules block roads, whether utilities can expand and whether occupied areas remain functional during removal.

Request Operational Documentation

Installation manuals alone are insufficient. The owner also needs maintenance schedules, cleaning requirements, spare parts, inspection forms, emergency procedures and training.

Connect Compliance to the Complete Camp

Individual modules may have technical evidence, but the completed settlement still includes site planning, foundations, fire strategy, sanitation, utilities and occupancy. The guide to modular building codes and permits explains why factory documents do not replace destination approval.

A Camp Data Room Should Be Organized Around Decisions

Project team reviewing population, masterplan, building, infrastructure and management data for a modular worker camp

The project data room should allow designers, suppliers, contractors and operators to work from the same assumptions.

Population and Operations File

  • Workforce profile and roster.
  • Shift and meal schedule.
  • Peak population by function.
  • Room and accessibility requirements.

Site and Masterplan File

  • Survey, drainage and geotechnical information.
  • Hazards, climate and access conditions.
  • Land-use zones and circulation.
  • Expansion and demobilization plans.

Building File

  • Room schedules and module configurations.
  • Structural, envelope and MEP requirements.
  • Fire, accessibility and maintenance information.
  • Factory and site inspection records.

Infrastructure File

  • Power, water, wastewater and communications models.
  • Peak loads, redundancy and storage.
  • Utility routes and connection points.
  • Monitoring and emergency operating levels.

Management File

  • Camp rules and responsibilities.
  • Cleaning, food safety and pest control.
  • Maintenance and work-order processes.
  • Security, medical and emergency procedures.
  • Resident feedback and grievance process.

A complete data room turns portable camp buildings into one coordinated settlement by preserving the relationships between people, buildings and services.

Red Flags in Worker Camp Quotations

  • The proposal begins with cabin quantity but contains no population or shift model.
  • Water, wastewater and power are expressed only as equipment lists with no peak-demand assumptions.
  • The supplier claims a complete camp while excluding kitchens, laundry, storage, medical, waste or maintenance functions without an interface plan.
  • Accommodation is placed before drainage, traffic and emergency access are resolved.
  • Dining capacity is based only on total seats rather than meal waves and turnover.
  • Sanitary capacity is calculated without cleaning downtime, accessibility or distributed walking distance.
  • Future expansion occupies the emergency or service route.
  • The camp has no protected utility zone or waste route.
  • The plan shows peak operation but no mobilization or demobilization configuration.
  • “Turnkey” is used without defining testing, commissioning, training and operating responsibility.
  • Local approvals are assumed to be covered by factory certificates.
  • The operator is appointed after design decisions have already fixed the maintenance and service model.

Focused FAQ

What is a detachable modular worker camp?

A detachable modular worker camp is a coordinated temporary or relocatable settlement built from modular facilities and supporting infrastructure. It normally includes accommodation, sanitation, dining, utilities, medical, administration, recreation, security, circulation and camp-management systems.

How is a modular labor camp different from a group of portable cabins?

A group of cabins provides enclosed spaces. A modular labor camp connects those spaces to population demand, utilities, WASH, food service, fire safety, access, maintenance and operations. The system relationship is the main difference.

What information is needed before requesting a camp quotation?

Provide the location, climate, workforce profile, peak population, shift pattern, project duration, occupancy types, room requirements, utility availability, food-service model, approval route and expected expansion or relocation plan.

How should accommodation capacity be calculated?

Start with peak and average occupancy, rotation, gender and privacy requirements, accessible rooms, visitors, supervisors and camp staff. Then define room types and bed quantities. Do not use one beds-per-cabin ratio as the complete capacity model.

Which facilities are essential in remote workforce accommodation?

Essential facilities depend on project conditions, but remote workforce accommodation commonly requires sleeping rooms, toilets, showers, handwashing, laundry, dining, food storage, medical support, administration, recreation, security, power, water, wastewater, waste handling and communications.

Why is WASH planning critical in worker camps?

Water, sanitation and hygiene operate as one chain. Failure in source, treatment, storage, hot water, fixtures, wastewater or cleaning can limit safe occupancy even when the accommodation buildings remain available.

What controls the layout of mining camp buildings?

Mining camp buildings should be arranged around shift patterns, noise, dust, transport, emergency access, utility routes, climatic exposure, expansion and separation between accommodation and industrial or service areas.

Can modular camp infrastructure expand with the workforce?

Yes, but the project must reserve land, utility corridors and scalable treatment capacity. Accommodation can often be added faster than power, water, wastewater, dining and road systems, so infrastructure phases must lead or match population growth.

What should be included in construction worker accommodation besides bedrooms?

Construction worker accommodation should include the facilities and management needed for hygiene, nutrition, rest, medical response, recreation, communication, security, maintenance and safe movement. Bedrooms alone do not form adequate accommodation.

Are portable camp buildings automatically easy to relocate?

No. Portable camp buildings need accessible connections, dismantling records, inspection, transport packaging and a suitable next site. Utilities, foundations and site-built additions may be less reusable than the modules.

How should a camp be planned for closure?

Define the population reduction sequence, minimum services that remain active, module removal routes, utility isolation, inspection areas, waste and site-restoration responsibilities and the future destination of reusable assets.

What is the most important camp procurement principle?

Procure the operating interfaces as carefully as the buildings. The strongest proposal clearly connects population, rooms, utilities, food, sanitation, safety, management, approvals and lifecycle responsibility.

The Camp Is Successful When Daily Life Works Without Improvisation

A worker camp should not be judged only on the day the modules are installed. Its real performance appears at the end of a shift, during a water interruption, at the dining peak, in heavy rain, when a resident reports a maintenance issue and when the workforce expands faster than expected.

The modular buildings matter. They provide speed, repeatability, transportability and the possibility of phased growth. But those advantages create value only when the settlement around them is planned as carefully as the rooms themselves.

A strong camp begins with a population clock, not a cabin count. It connects accommodation to WASH, food, utilities, movement, safety and management. It separates sleeping from noise and service traffic. It protects emergency routes. It plans for expansion and removal. It defines who owns every interface. It preserves records for the next project.

That is the industry-level meaning of a worker camp system. It is not a row of temporary boxes. It is a small city with a project deadline—and it should be designed, procured and operated with that level of responsibility.

#DetachableWorkerCamp #ModularLaborCamp #RemoteWorkforceAccommodation #MiningCampBuildings #ConstructionWorkerAccommodation #CampInfrastructure #WorkforceHousing #RemoteSitePlanning #WASH #ModularConstruction
