Expandable vs Detachable vs Flat-Pack Buildings: What Really Changes?

July 20, 2026

Three Similar-Looking Products Can Create Three Very Different Projects

A buyer can place three supplier brochures side by side and see almost the same promise: a steel-framed room, insulated wall panels, fast delivery, flexible layouts and lower site work than conventional construction. One brochure calls the product an expandable modular building. Another offers a detachable container house. A third promotes a flat pack container house. Their completed rooms may look similar in photographs, but the projects behind those photographs are not the same.

The meaningful difference is not the exterior color, the number of bedrooms or whether the brochure uses the word “container.” It is the sequence through which the building moves from factory to truck, from truck to site and from a transported package to a code-compliant occupied space. That sequence determines shipping density, factory completion, local labor, lifting strategy, weatherproofing risk, commissioning time, repairability and total installed cost.

This is why a useful modular building comparison must examine three states rather than one finished image:

  1. Transported state: What is physically inside the shipment, how complete is it and where are its lifting points?
  2. Transformation state: Does the site team unfold, slide, bolt, seal or fully assemble the building?
  3. Occupied state: Which joints carry load, keep out water, control air leakage and connect utilities after installation?

Once buyers evaluate those three states, marketing labels become less confusing. The product can be selected as a building system rather than as an attractive object.

First Separate Four Terms That Suppliers Often Mix Together

The international market does not use one perfectly controlled vocabulary for compact modular units. Different factories, distributors and regions may use the same name for different assemblies. A specification should therefore define the physical system and never rely on the product name alone.

Expandable describes how occupied area is created

An expandable unit travels in a compact configuration and creates a larger floor area after one or more sections fold or slide outward. A common double-wing design uses a central core with hinged floor, roof and wall elements on both sides. Other products use slide-out rooms or telescoping frames. The defining feature is built-in movement: the transported module contains an expandable house structure that becomes wider or longer during deployment.

Many components may already be installed in the central core, including a bathroom, distribution board, plumbing manifold, kitchen services or fixed cabinetry. This can raise factory completion and reduce field work. It also concentrates technical responsibility around hinges, locks, seals, flexible service connections and the transition between fixed and moving sections.

Detachable describes how the assembly comes apart

A detachable system is designed so that major structural members, frames, panels or both can be separated for transport, replacement or later relocation. Some products use bolted columns connected to roof and floor frames. Others use a welded structural cage with removable infill panels. The label detachable container house therefore does not reveal enough by itself; buyers must ask exactly which parts are welded, which are bolted and which must be resealed after reassembly.

The absence of large folding wings can simplify the occupied-state geometry, but it transfers more work to the site. Alignment, bolt control, temporary stability, panel installation and joint sealing become installation activities rather than factory-completed activities.

Flat-pack describes shipping form, not one exclusive structural species

A flat pack container house is shipped as compact layers, cassettes or component bundles instead of as a fully volumetric room. The package may contain pre-welded floor and roof frames, loose columns, wall panels, windows, doors, fasteners and service components. Another flat-pack product may arrive more completely disassembled.

This creates an important overlap: a building can be both detachable and flat-packed. “Detachable” tells the buyer about disassembly and connection logic; “flat-pack” tells the buyer about packaging and transport density. Treating them as mutually exclusive categories can produce an inaccurate tender and an unfair price comparison.

Container may describe proportions without proving cargo-container status

Many purpose-built modular products use widths or lengths associated with freight logistics and are marketed as container houses. That does not automatically mean they are converted shipping containers or certified freight containers. A product with container-like dimensions may use different frames, corner details, loads and lifting procedures. Buyers should request the actual transport drawing and lifting method instead of assuming that an architectural unit can be handled, stacked or shipped like an ISO freight container.

These systems all sit within the wider family of prefabricated building systems, but family membership does not make them operationally interchangeable.

The Real Comparison Begins Before the Building Reaches the Site

Transport density rewards disassembly, but density is not free

A completed volumetric module transports air as well as building materials. Compact systems try to reduce that inefficiency. Fully or substantially disassembled packages generally use cargo volume more efficiently than a pre-finished expandable module, while an expandable unit usually transports more efficiently than a room delivered at its full occupied width. The exact loading quantity depends on package dimensions, unit weight, internal fit-out, shipping route and carrier restrictions; it should never be copied from a generic brochure.

Higher packing density can reduce ocean freight per unit, but it also moves value-creating work from the factory to the destination. Every frame connection, wall joint, window interface and service connection completed on site requires labor, supervision, tools, tolerances and weather protection. A procurement team should not celebrate an extra unit per container until it has priced the work created by that extra density.

Damage risk changes rather than disappearing

An expandable module may protect factory finishes inside its folded shell, yet hinges, projecting hardware, glazing and integrated interiors can still be sensitive to twisting, vibration or incorrect lifting. A disassembled package avoids transporting a finished room, but loose panels can suffer edge damage, moisture exposure, abrasion or bundle movement. Hardware can be lost, mixed between units or delivered in the wrong sequence.

Packaging plans should identify bundle numbers, center of gravity, lifting points, moisture protection, maximum stacking loads and the order in which components are needed. A package that is dense but impossible to unload in erection sequence can create double handling and site congestion.

The last kilometer can reverse the preferred system

Crane lifting a prefabricated modular building from a delivery trailer onto prepared site foundations

A wide or heavy integrated module may need a crane, open access and an adequate turning radius. Component bundles may reach constrained sites using smaller vehicles and manual or light-mechanical handling, although more assembly space will then be required. An apparently cheaper portable modular building can become expensive if the delivery vehicle cannot reach the foundation or if the project must hire specialized lifting equipment for a single unit.

Site access should be surveyed before the purchase order. Gate width, overhead lines, bridge limits, road gradient, ground bearing capacity, crane radius, storage area and seasonal weather are procurement inputs, not installation details to solve later.

What Actually Happens During Transformation?

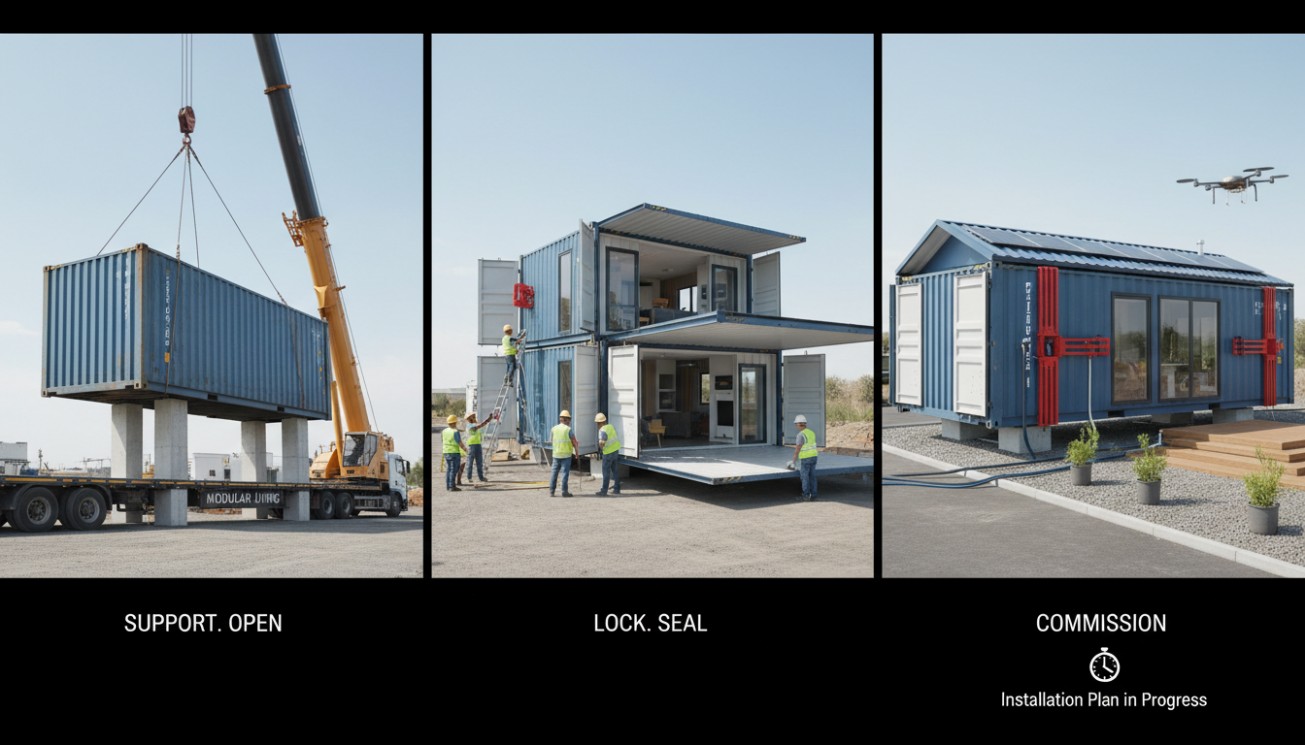

The expandable sequence: support, open, lock, seal and commission

Three-stage expandable house deployment sequence showing support, opening, locking, sealing and commissioning

A typical expandable container house arrives as one integrated transport unit. After it is unloaded onto prepared supports, the team confirms level, releases transport restraints, supports the moving sections and unfolds or extends them according to the manufacturer’s method. Floors and roofs are brought into position, end walls are closed, structural locks are engaged, transition flashings or seal components are completed and utilities are connected.

Opening time is not occupancy time

A social-media video may compress this sequence into minutes, but opening the shell is not the same as completing the building. Level correction, anchorage, weather seals, drainage, utility testing, protective devices, interior touch-up and authority inspections still matter. The fastest visible movement is only one task in the installation plan.

Keep complex services inside the stable core

The strongest use case for a fold out prefab house is usually a project that values high factory completion and low field labor more than maximum shipment density. The central service core can keep the most complex plumbing and electrical work away from moving edges. However, a poor layout that carries rigid pipes or fragile finishes across hinge lines can destroy that advantage.

The detachable sequence: establish the frame before closing the envelope

A detachable package may require the site team to set the floor frame, connect columns, temporarily brace the assembly, place the roof frame, verify geometry and torque structural fasteners before installing panels. Doors, windows, flashings, trims and MEP components follow in a defined order. The building only becomes stable and weather-resistant when the specified load path and envelope details have been completed.

This process is less dramatic on video but can be highly efficient at project scale. A trained crew can repeat the same operation across many standardized units, use jigs and inspection gates, and distribute lifting resources across the site. The commercial advantage grows when local labor is available, the design is repetitive and shipping cost is a major part of landed cost.

The flat-pack sequence depends on what “flat” contains

One flat-pack package may use factory-welded roof and floor cassettes that are joined by columns. Another may require more extensive frame assembly. A third may include preinstalled electrical runs in panels but leave bathroom construction to local trades. Installation hours cannot be compared until the scope boundary is visible.

For every bid, buyers should request a responsibility matrix that identifies factory work, supplier-supervised work, local contractor work and excluded work. Phrases such as “easy assembly” or “plug and play” are not measurable scopes.

Each System Concentrates Risk in a Different Interface

All buildings have interfaces. Compact modular systems do not eliminate them; they relocate and multiply them differently. An industry-level assessment asks where each design stores its uncertainty.

Expandable risk is concentrated at moving joints

Project team inspecting moving joints and service connections on expandable modular building units

The moving interface must perform structurally during deployment and environmentally during occupancy. Buyers should examine hinge pins, weld access, locking devices, floor transitions, roof laps, compression gaskets, sealant geometry, drainage paths and replaceability. The deployed frame must transfer gravity and lateral loads without treating the hinge as an undefined detail.

Water should be managed in layers. An exterior overlap or flashing should shed bulk water; a secondary seal should resist wind-driven rain; drainage should direct incidental moisture outward. Relying on one exposed bead of sealant at a repeatedly moving joint is not a durable strategy. The inspection plan should include a controlled water test after deployment and again after any relocation.

Detachable risk is concentrated at field-created connections

Bolted construction can be inspectable and repairable, but only when the drawings define bolt grade, diameter, washer arrangement, tightening method, access and corrosion protection. Missing fasteners, hole misalignment and uncontrolled field drilling can change the load path. Reassembly also requires a method for deciding when fasteners, gaskets or damaged panels must be replaced rather than reused.

Envelope performance depends on installer consistency. Panel splines, corner trims, roof-to-wall transitions, openings and base details must be installed in the right sequence. A highly engineered factory kit can still leak if the site crew improvises a junction.

Flat-pack risk is concentrated at scope and logistics boundaries

The buyer may believe a flat-pack price includes a complete room while the supplier has priced a structural shell. Finishes, sanitary fixtures, cables, breakers, plumbing, sealants, foundations, cranes, commissioning and local certifications may sit outside the quotation. The package can also arrive efficiently but in a sequence that does not match the erection schedule.

The solution is configuration control: one approved bill of materials, one drawing revision, unit-by-unit packing lists, traceable hardware kits and clear acceptance criteria. Logistics efficiency is valuable only if completeness and traceability survive the journey.

Factory Completion Versus Site Flexibility Is the Central Trade-Off

Higher factory completion normally improves repeatability because work occurs under controlled conditions with stable tools, fixtures and inspection access. It can also shorten exposure to rain and reduce the number of destination trades. This is one reason an expandable modular building can be attractive for dispersed projects, remote sites or markets with expensive field labor.

Yet factory completion constrains late changes. A fully fitted central core has fixed service positions, transport weight and a defined relationship to the folding geometry. The project cannot casually move a bathroom wall after delivery. Repair access may also be limited if services are hidden inside compact assemblies.

Greater site assembly offers the opposite profile. A flat pack container house or detachable kit can adapt openings, cladding or room combinations more easily when the design anticipates those options. Local materials may be integrated, and damaged infill panels may be replaced individually. But flexibility creates more opportunities for dimensional variation, substitution and workmanship differences.

The correct choice is not “more factory work is always better” or “more shipping density is always cheaper.” The choice is where the project has the strongest control system. If the factory is well controlled and the destination has limited skilled labor, increase factory completion. If the site has a trained repetitive-installation team and freight dominates the budget, more compact component shipment may be rational.

Compare Total Installed Cost, Not the Supplier’s Unit Price

The factory quotation is only the first layer of cost. A defensible comparison calculates the same completed scope for every system:

Total installed cost = factory package + export packing + freight + duties + inland delivery + unloading and lifting + foundations + assembly labor + utility connections + inspections + commissioning + defects reserve.

The model should also include schedule cost. Earlier occupancy may have economic value for a hotel, clinic, classroom, sales office or workforce camp. Conversely, purchasing rapid-deployment units before permits, foundations or utilities are ready creates storage cost without accelerating revenue.

Use four normalization rules

  1. Compare the same usable area. Folded transport dimensions are not occupied floor area.
  2. Compare the same completion level. A shell is not equivalent to a fitted building.
  3. Compare the same site performance. Structural loads, thermal targets, fire requirements and service standards must match.
  4. Compare the same delivery point. Ex-works, port-delivered and installed prices are different commercial products.

This approach often changes the result of a modular building comparison. A higher factory price can win where local labor and schedule are costly. A lower-cost disassembled kit can win across hundreds of repeated units with trained crews. Neither result is universal.

A Practical Decision Matrix for Real Projects

Decision factor Expandable system Detachable system Flat-pack offer
Transport form Integrated compact module with moving sections Major parts designed for separation and reassembly Components or cassettes bundled in compact layers
Typical factory completion Potentially high, especially in the fixed core Moderate and dependent on frame concept Ranges from structural kit to partially fitted package
Main site activity Unfold or extend, lock, seal, anchor and commission Assemble frame and panels, seal, connect and inspect Unload in sequence and assemble the quoted scope
Primary quality interface Hinges, locks, moving services and weather seals Bolted joints, geometry, bracing and field sealing Scope completeness, packing control and site workmanship
Best commercial condition Fast dispersed deployment with limited local labor Repeated assembly, repairability and planned relocation Freight-sensitive, standardized projects at scale
Question that decides the purchase Can the moving interfaces meet site performance? Can the field team reproduce the approved assembly? What exactly is included and how is it sequenced?

When expandable is often the better starting point

Consider an expandable container house when units are distributed across several small sites, rapid enclosure matters, destination labor is scarce or expensive, and a standardized fitted core solves most service needs. It may suit single-level accommodation, site offices, temporary clinics, sales spaces or hospitality rooms when site-specific engineering and approvals support the application.

Do not select it only because deployment footage looks fast. Verify wind, snow, seismic and floor loads; foundation reactions; joint water management; thermal bridges; anchorage; electrical and plumbing compatibility; lifting; and permitted use. A building intended to remain deployed for years should be evaluated for years of exposure, not minutes of opening.

When detachable is often the better starting point

Consider a detachable container house when compact transport, replaceable components and planned disassembly are important, and the project can support a controlled installation crew. It can be useful for camps, project offices, classrooms, clinics and repeat-use fleets, provided the structure and connection details match the loads and relocation plan.

Ask how many assembly cycles the design basis considers and what inspection occurs between cycles. “Reusable” is not a permanent property. Bolts, coatings, seals, panel edges and service connections accumulate damage. A relocation manual should define acceptance, repair and retirement criteria.

When a flat-pack strategy is often the better starting point

Consider a flat pack container house offer when shipping density and large-scale repetition drive project economics. A mining camp or construction accommodation project with hundreds of standardized rooms can justify crew training, jigs, staged inspections and organized material yards. The same system may be less attractive for one isolated building where mobilizing labor and equipment overwhelms the freight saving.

Because flat-pack is a delivery description, compare the actual assembly, not the category name. The technical proposal should state whether floor and roof frames are welded, how lateral stability is achieved, which panels are structural, how units connect and whether multi-story use is included in the engineered design.

Do Not Let Portability Become a Structural Claim

The phrase portable modular building can mean that a unit is transportable once, relocatable several times or merely smaller than conventional construction. Those are different design conditions. A building moved repeatedly experiences lifting, racking, vibration, temporary support and reconnection loads that a permanently installed unit may never experience.

Relocation planning should identify lift points, temporary bracing, center of gravity, maximum transport acceleration, permissible panel damage, seal replacement and MEP isolation. If the unit is to be stacked, connected side by side or installed above ground level, the engineer must evaluate the deployed configuration and every inter-module connection. Freight-like corner details alone do not prove building-stack performance.

The same caution applies to the words “temporary” and “emergency.” Short use does not remove obligations for structural safety, fire protection, sanitation, accessibility, electrical protection or safe egress. The applicable requirements are determined by jurisdiction, occupancy and installation, not by a seller’s category label.

Codes Evaluate the Completed Building, Not the Brochure Name

Offsite construction changes where work occurs; it does not automatically create a separate safety standard or a permit exemption. Regulators may need to review factory-concealed work, site completion, foundations, utility connections and final occupancy. The approval route varies by country, state, province and municipality.

A project team should determine the legal pathway before production. It must identify the authority having jurisdiction, adopted building codes, land-use conditions, occupancy classification, design loads, energy requirements, fire and egress provisions, accessibility obligations, sanitation rules and inspection responsibilities. A residential-looking unit is not automatically approved as a dwelling, accessory dwelling unit or manufactured home.

For internationally sourced prefabricated building systems, the buyer should establish who holds design responsibility in the destination market. Factory drawings may describe production accurately yet still require review, adaptation or sealing by an authorized local professional. Electrical devices, cable types, plumbing fittings and protective equipment must also match destination requirements rather than the factory’s default configuration.

The Twelve Documents That Turn a Product Quote into a Building Proposal

A serious request for quotation should demand evidence that follows the building through all three states. At minimum, request:

  1. Transported and deployed general-arrangement drawings with dimensions and weights.
  2. A structural basis of design identifying materials, loads, analysis assumptions and connection logic.
  3. Foundation reactions, support layout, anchorage requirements and leveling tolerances.
  4. Lifting, unloading, erection or unfolding instructions with temporary-stability controls.
  5. Envelope sections for roof, base, corners, openings and every moving or field-assembled joint.
  6. Thermal data that includes panels, framing, junctions and climate-appropriate condensation control.
  7. Fire-performance evidence for the relevant complete assemblies, not only a core-material brochure.
  8. Electrical, plumbing, ventilation and drainage diagrams adapted to the destination.
  9. A factory inspection and test plan with hold points for concealed work.
  10. A unit-specific packing list and component traceability method.
  11. A site commissioning checklist covering structure, water, air, power, drainage and life-safety items.
  12. A maintenance, relocation and spare-parts plan defining replaceable seals, hardware and finishes.

For an expandable house structure, add hinge loads, lock details, deployment clearances, flexible-service arrangements and joint water tests. For a detachable system, add bolt schedules, tightening procedures, bracing stages and reassembly acceptance rules. For a flat-packed offer, add bundle sequencing and a precise factory-versus-site scope matrix.

A Better Selection Method: Buy the Project Sequence

Five-step modular building selection process from defining project needs to validating a pilot unit before scale

Procurement often begins with a catalog and ends with a request for the lowest unit price. A better method begins with the destination operating model.

Step 1: Define the occupied outcome

State the occupancy, expected service life, usable area, climate, loads, comfort level, accessibility, fire strategy, finish quality and utility needs. Avoid choosing a mechanism before defining what the finished building must do.

Step 2: Map destination constraints

Record shipping route, site access, crane availability, local labor rate, crew skill, storage area, weather window, utility readiness, inspection pathway and schedule value. These variables decide whether factory completion or packing density creates more value.

Step 3: Compare transformation work

Ask every bidder for task hours, crew size, tools, lifting equipment, exclusions and inspection gates. A deployment time is meaningful only when its start and finish conditions are defined. “Ten minutes” may mean opening the wings, while “one day” may mean a commissioned room; those claims cannot be compared.

Step 4: Price risk and repetition

A one-unit pilot and a 500-unit camp have different economics. Repetition can justify specialist crews and quality stations. Dispersed installation can favor a more complete fold out prefab house. Include contingency for field defects, missing parts, weather delays and rework rather than assuming every unit follows the demonstration video.

Step 5: Validate before scale

Inspect a representative unit in transported, transformation and occupied states. Observe lifting, deployment or assembly. Measure critical geometry, inspect concealed interfaces before closure, test utilities, conduct specified water tests and record the complete labor input. Freeze the accepted design and packing configuration before mass production.

This is the most reliable way to procure an expandable modular building or any competing compact system: validate the whole sequence, not only the showroom result.

Focused FAQ

What is the main difference between expandable, detachable and flat-pack buildings?

Expandable describes a building that increases usable area through integrated folding or sliding sections. Detachable describes a system whose major components can be disconnected and reassembled. Flat-pack describes a compact shipping form. A detachable product can therefore also be flat-packed, while an expandable product normally arrives as a more integrated movable assembly.

Is a flat-pack building always cheaper than an expandable building?

No. It may reduce freight cost per unit, but it normally creates more unloading, assembly, sealing, supervision and commissioning work at the destination. Compare total installed cost for the same usable area, completion level and site performance.

Is an expandable building the fastest option?

It often has the shortest shell-deployment sequence because much of the unit can be factory assembled. Actual readiness still depends on foundations, leveling, anchorage, weatherproofing, utilities, inspections and commissioning. Opening time should never be presented as occupancy time.

Is a container house made from a shipping container?

Not necessarily. Many purpose-built modular buildings use container-like dimensions for transport or marketing but have their own frames, panels and lifting details. Request design and transport documentation; do not infer freight-container certification from appearance or name.

Which system is better for repeated relocation?

The answer depends on the designed relocation cycle, connections, finishes, seals, service isolation and inspection plan. Detachable systems can offer component repairability, while expandable units can reduce each deployment’s field assembly. Neither should be assumed infinitely reusable. Ask for cycle-related design evidence and replacement criteria.

Can these buildings be stacked?

Only when the specific deployed system, inter-module connections, foundations, fire strategy, access and local codes support stacking. Corner posts or container-like fittings do not prove multi-story capacity. Require project-specific engineering.

Do compact modular buildings need foundations and permits?

Usually they require a verified support and anchorage solution, and many installations require planning, building, utility or occupancy approvals. Requirements vary by location and use. “Portable,” “temporary” and “prefab” are not universal exemptions.

Which system performs best in extreme climates?

Climate performance depends more on the complete envelope, structural design, joints, thermal bridges, ventilation, moisture control, loads and installation quality than on the category name. Expandable joints and detachable field seams need particular scrutiny, but either system can succeed or fail depending on engineering.

What is the first question a buyer should ask a supplier?

Ask for drawings showing exactly what the unit looks like during transport, during deployment or assembly, and after completion. Then ask who performs and verifies every task between those states. That answer reveals more than a generic price list.

The Best System Is the One Whose Interfaces Match the Project

Expandable, detachable and flat-pack buildings are not three price levels of the same object. They are different ways of allocating space, labor, logistics and quality control across a project. Expandable systems exchange some packing density and mechanical simplicity for higher integration and faster field transformation. Detachable systems exchange factory completion for compact logistics, replaceability and planned reassembly. Flat-pack offers describe transport efficiency, but the actual structural and scope logic must still be uncovered.

The right decision comes from following the building through its complete life: factory fabrication, export packing, transport, unloading, transformation, approval, occupancy, maintenance and possible relocation. A buyer who evaluates only the finished room sees the least informative state. A buyer who evaluates the interfaces can predict cost, risk and performance.

That is the strategic value of offsite construction. It does not remove construction; it gives the project team an opportunity to place each activity where it can be controlled best. The winning system is therefore not the one with the most impressive folding video or the smallest factory quote. It is the one whose transported state, transformation method and occupied performance fit the destination’s real constraints—and whose evidence proves that fit before volume production begins.
